Homer Glen · Wastewater Treatment Plant

Per the Illinois EPA’s summary of the Village’s plan:$16 millionto serve one business —and 114 homes not built yet

Those are the customers the state’s summary projects: the one business Lockport treats for the Village today, and 114 homes it says will be developed within the next five years. The Village’s own video says the first phase is sized for about 2,500 residents. It puts the project at $15,968,320 and projects a flat sewer bill of $105 a month for those homes in 2030, rising to $125. To repay the loan it counts on those bills, a per-1,000-gallon charge to commercial users, and a “proposed Village subsidy” of $561,135 in the first year — a subsidy the Village’s February video never mentions. That video told residents the plant would be paid for by “future growth and not current Illinois American Water customers”; the summary doesn’t say where the subsidy money comes from. The plant is a real need, and Heidi is not asking the Village to cancel it. So far as we can find, the bill and the subsidy have reached residents only as scanned state pages — in a 147-page hearing packet, and on slides at the July 8 hearing, where no one read them aloud. Here is what the record shows, with a link to every source.

Exhibit A

The numbers in the state’s summary

In June 2026 the Illinois EPA summarized the Village’s plan for a state loan to build the plant — its cost, its financing, its customers and their bill — working in part from the Village’s own September 2025 project plan. The Village attached that summary to the packet for its July 8, 2026 public hearing, as scanned pages with no searchable text.

Excerpt of page 4 of the Illinois EPA’s Project Summary and Preliminary Environmental Impacts Determination, dated June 16, 2026, as attached to the Village’s July 8, 2026 hearing packet. Highlights added. “Cost of service” here means a Village sewer bill, not an Illinois American Water bill: $0.00 today (the summary says the Village’s own sewer currently carries one commercial customer’s flow to Lockport), and $125.00 projected for the plant’s new homes. Open the full page · sources.
Transcribed

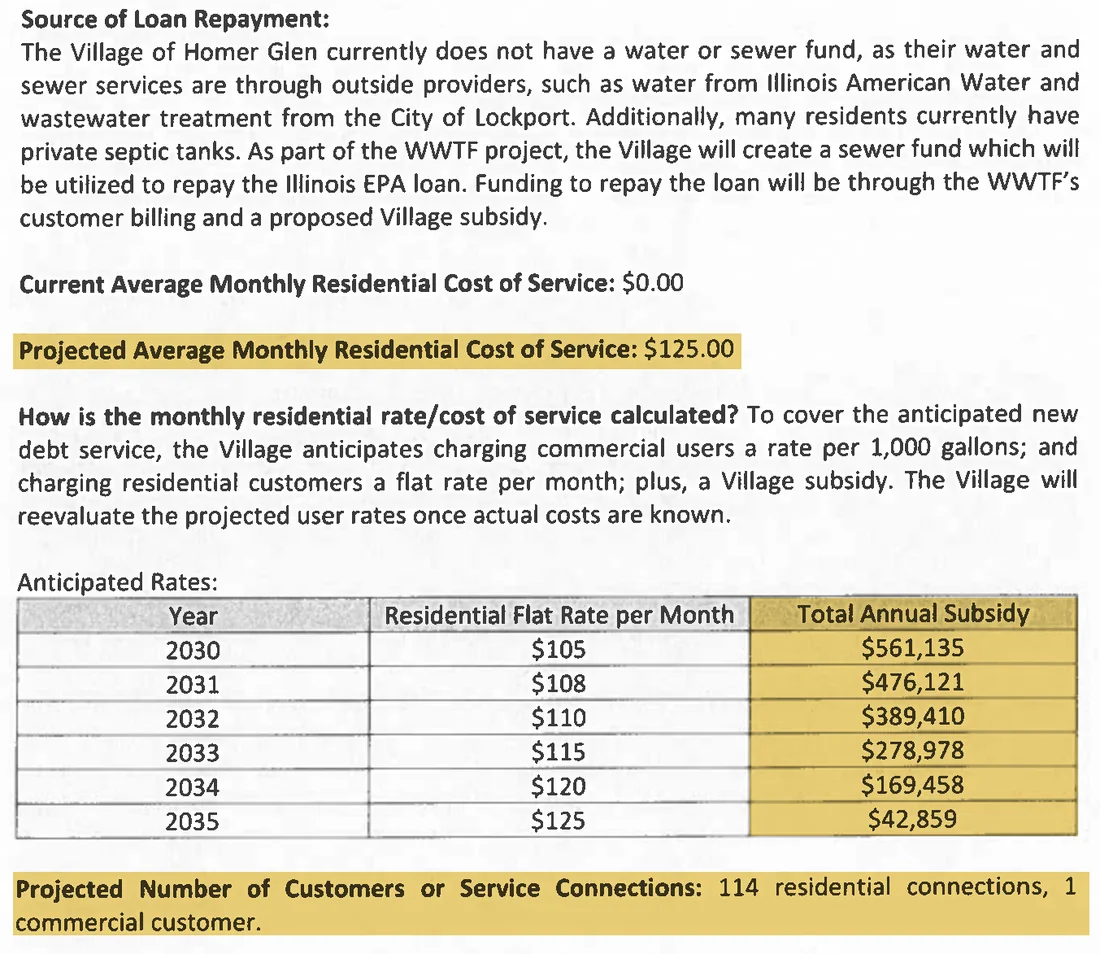

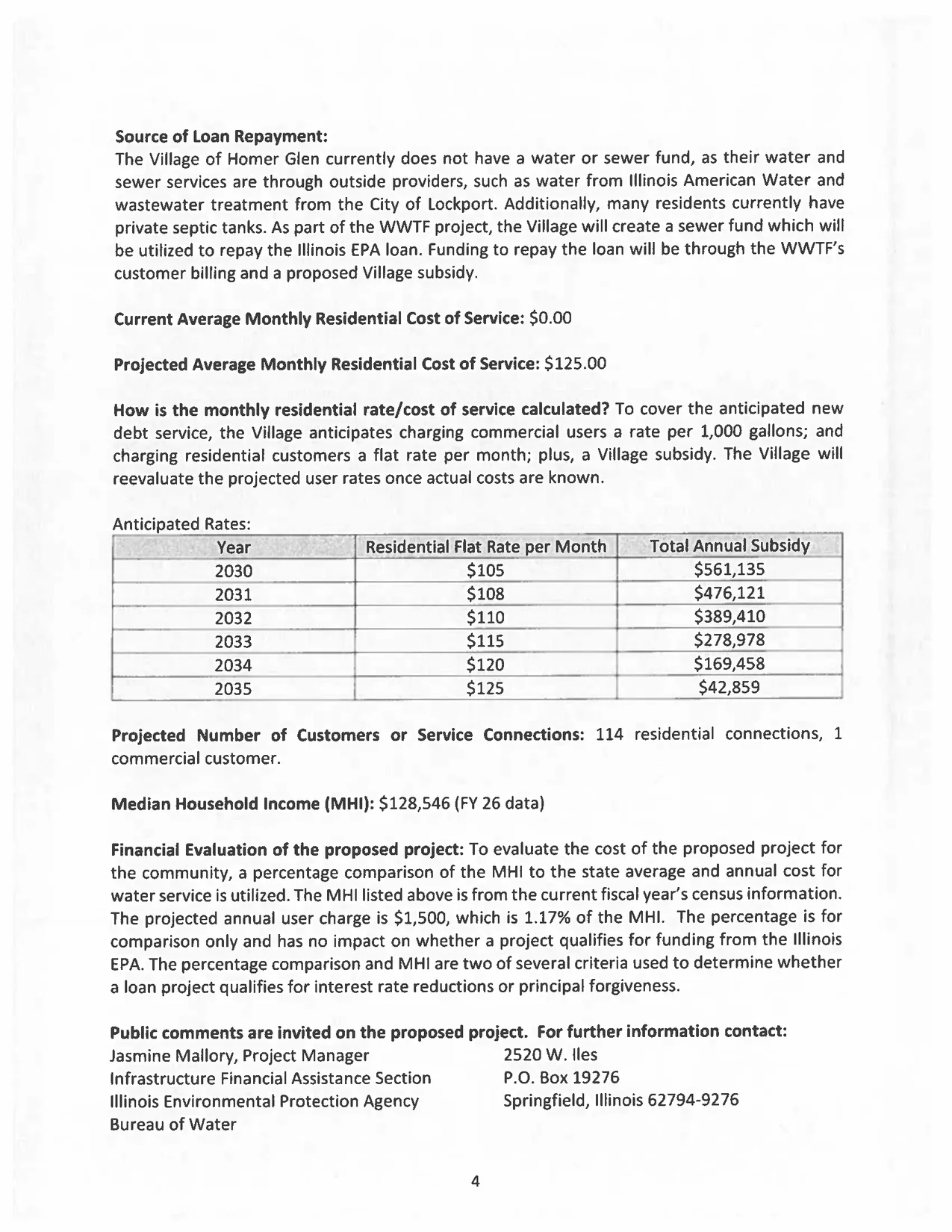

Illinois EPA · Project SummaryDated June 16, 2026
Project cost estimate$15,968,320
State loan20 years at est. 2.16% — about $983,960 a year
Repaid throughcustomer billing and “a proposed Village subsidy”
Projected customers114 residential connections, 1 commercial customer
Anticipated rates
YearFlat rate per home, per monthVillage subsidy
2030$105$561,135
2031$108$476,121
2032$110$389,410
2033$115$278,978
2034$120$169,458
2035$125$42,859
Subsidy, 2030–2035$1,917,961
Transcribed from pages 2–4 of the Illinois EPA summary in the Village’s July 8, 2026 hearing packet; the six-year subsidy total is the sum of its table. The summary says the Village “will reevaluate the projected user rates once actual costs are known.”
$16.0M
Project cost estimate
$15,968,320, in the Illinois EPA’s summary of the Village’s plan (June 16, 2026)
1 + 114
Projected customers
Per the state summary: the one business Lockport treats today, plus 114 homes it says will be developed within the next five years. The Village’s video sizes the first phase for about 2,500 residents
$105–125
Projected monthly sewer bill
Flat residential rate for the plant’s customers, 2030 to 2035 — trustees set it by ordinance
$561K
Village subsidy, first year
A “proposed Village subsidy” of $561,135 in 2030, falling to $42,859 by 2035 — about $1.9 million over six years
2030
Lockport deal ends
Lockport stops treating the Village’s own sewer flow on January 1, 2030 — the deadline behind this project
Sewage
What it treats
Not drinking water — that comes from Illinois American Water, your own well, or, along 159th Street, a Village-owned water main

Where Heidi stands

This is very likely a genuine, necessary infrastructure project — Heidi isn’t asking the Village to stop it. What she is asking for is what still hasn’t happened: explain the cost, the loan and the projected bill to residents in plain language, on the plant’s own page on the Village website and in the Village newsletter; explain the proposed Village subsidy — where the money comes from, how it fits the Village’s word that growth pays for the plant, and what happens if fewer than 114 homes connect; give residents on septic an answer in writing; and set the Village sewer rate in public, with the math shown, because the same Board that approves the plant sets that rate by ordinance. The numbers exist. Residents shouldn’t have to find them as scanned pages in a hearing packet.

Gougar RdCedar RdParker RdBell RdWill-Cook Rd135th St143rd St151st St159th St167th StHomer GlenFiddyment Creeksewer area (approx.)Plant site159th & Gougar · ~30-acre Village parcel

Exhibit B

Who the plant is for

The Illinois EPA summary says the plant “will serve” the commercial customers Lockport treats today “as well as 114 residential units that will be developed within the next 5 years,” and counts its projected customers as 114 homes and one business. It prints that count just below its rate and subsidy table. Under the heading “How is the monthly residential rate/cost of service calculated?” it names the pieces (a flat residential rate, a per-1,000-gallon commercial charge and a Village subsidy) but shows none of the arithmetic: no revenue by year, no connection schedule, and nothing on why the subsidy falls from $561,135 to $42,859. Homes on septic, it says, can connect “when they are ready.”

At the July 8 hearing, Village Engineer Brett Westcott said the plant “is not being designed to serve existing customers who are served by Illinois American” wastewater plants. Its planning area, he said, runs from the plant site out to Parker Road — “this largely undeveloped area and unserved area.” A consultant’s January 2, 2025 proposal in the Village’s Board packet describes the same area as “generally bound by 151st Street, 159th Street, Gougar Road, and Parker Road.”

The plant starts at 0.25 million gallons a day, planned to grow to 0.5 once it reaches 80% capacity; the Village’s February 2026 video says the first phase will serve “about 2500 residents” and that at full buildout the plant would serve about 3,000 acres. Its site is about 30 acres at 159th Street and Gougar Road, bought for $4,000,000 in October 2024. And the $2,591,009.72 Cedar Road sewer extension the Board awarded on June 10, 2026 — paid from the same budget account as the plant — runs into this same area.

  • Village of Homer Glen
  • Fiddyment Creek sewer area, drawn approximately from the Village Engineer’s description and a proposal in the Village’s Board packet
  • Plant site, 159th & Gougar

Village boundary © OpenStreetMap contributors (ODbL). Service area drawn from the Village Engineer’s July 8, 2026 description and a consultant’s January 2, 2025 proposal in the Village’s January 22, 2025 Board packet — a description, not a parcel line. More on the sewer extension.

How do we know those 114 homes will be built?

The state summary doesn’t say. It never says where the 114 homes are, who would build them, or whether anyone has approved them, and we found no mention of the number in the recording of the July 8 hearing.

The only 114-home plan we found in the Village’s own records is in a June 2023 draft feasibility study by Robinson Engineering, which the Village has posted on its website. Its table of “Anticipated Short Term Population Growth in Service Area” lists about 50 acres on 159th Street east of Cedar Road as a “Conceptual Site Plan showing 114 residential Lots, no commercial” — on the stretch of 159th Street that the $2.6 million Cedar Road sewer extension was awarded to serve. The study called its table “a possible short-term forecast of development” whose buildout “would likely take at least the next several years.” The number matches; the state summary doesn’t say whether that is where its 114 came from.

Table 1 of Robinson Engineering’s “Wastewater Treatment Facility Feasibility Analysis,” June 29, 2023 draft, as posted on the Village website. Highlight added; a private landowner’s name is covered. Open the full page · sources.

Three years later, the 50 acres in that table are still vacant: the Village’s June 2026 bid memo describes the parcels its new sewer will reach, along the north side of 159th Street, as “currently unserved vacant parcels,” and we found no zoning request, subdivision plat or Village approval for homes on that land in Plan Commission or Village Board agendas from January 2024 through September 2026. (A separate, larger plan on the south side of 159th — Dunn Farm, proposed at 241 homes and later cut to 217 — has been to Village workshops in April and October 2025; we found no approval for it.) The Village’s own consultant gave an answer in 2023, in the same study: developers had approached the Village, but it was “limited in its ability to process development applications” without “economical and long-term infrastructure being readily available.” So the homes may well follow the pipe. But the state summary counts on them within five years, and beyond a line that the Village “will reevaluate the projected user rates once actual costs are known,” it doesn’t say what happens to the bill or the proposed subsidy if they come slower — or not at all.

Whose sewer bill this is

It depends on whose sewer you are on. If Illinois American Water handles your sewage — it runs three wastewater plants inside Homer Glen — the Illinois Commerce Commission sets that rate, and the Village’s own video says this project will not affect existing Illinois American Water customers. If you are on septic, you have no sewer bill today, but you are not outside this plan: the state summary says septic homes can connect “when they are ready,” and the Village’s video says more extensions are being studied to serve nearby unsewered neighborhoods. The customers the summary actually projects are the Village’s own sewer customers: today one business, and within five years, 114 new homes.

For them, the Village’s audited financial statements say who decides:

“[S]ewerage services will be provided under an enterprise fund concept, with user charges set by the members of the Board of Trustees to ensure adequate coverage of operating expenses.”
— Village of Homer Glen Annual Comprehensive Financial Report, year ended April 30, 2025

And the Village’s plan, as the state summarizes it, already projects the number: a flat charge of $105 a month per home in 2030, rising each year to $125 in 2035 — $1,500 a year, which the summary puts at 1.17% of Homer Glen’s median household income. To repay the loan it adds a per-1,000-gallon charge to commercial users and a “proposed Village subsidy”: $561,135 in 2030, falling to $42,859 in 2035 — about $1.9 million over six years, by our sum of its table. The summary does not say where the subsidy money comes from. In February the Village told residents the project would be paid for by “future growth and not current Illinois American Water customers,” through loans, possible grants and “connection fees from new users.” The subsidy is a separate line from customer billing, and neither document says whether it would come from those connection fees or from other Village money. The summary says the Village “will reevaluate the projected user rates once actual costs are known.”

Whatever the final number, it will be set the same way: by six trustees, by ordinance — no referendum, and no Illinois Commerce Commission rate case of the kind that governs Illinois American Water.

What’s actually being built

This project treats sewage (wastewater) only. It changes nothing about where your drinking water comes from: Illinois American Water where it serves, your own well elsewhere. The two are easy to mix up because Illinois American Water also runs three wastewater plants inside Homer Glen — but the Village’s new plant is a separate, Village-owned facility.

The Illinois EPA summary describes a screening structure, an Aero-Mod treatment system, sludge holding tanks, disc filtration, UV disinfection, a building for a laboratory, electrical room and blowers, and a new lift station and force main — north of 159th Street, east of Gougar Road, discharging into Fiddyment Creek. Construction is projected from January 2028 to January 2030.

Why it exists: under a 2018 intergovernmental agreement, Homer Glen, the City of Lockport and the Bonnie Brae–Forest Manor Sanitary District arranged for the flow from the Village’s own Fiddyment Creek sewer to be treated at Lockport’s Bonnie Brae plant. Lockport has given notice that it will end that arrangement on January 1, 2030. Without its own plant, the Village would need another outside provider — a new agreement with Lockport, or Illinois American Water — both for that flow and for the new homes and 159th Street parcels it is planning for; under the current agreement, Lockport had already refused any new connections in 2022.

Exhibit C

The line in the budget

The plant also has a line in the Village’s own budget. On April 22, 2026 the Board adopted its budget for fiscal year 2026-27; inside the Capital Project Fund, account 70-00-85-630, “WWTP PROJECT,” is budgeted at $15,487,279.

From printed page 34 of the adopted FY2026-27 budget, exactly as the Village posted it — a scanned PDF with no searchable text. Highlight added. Open the full page · sources.
Transcribed

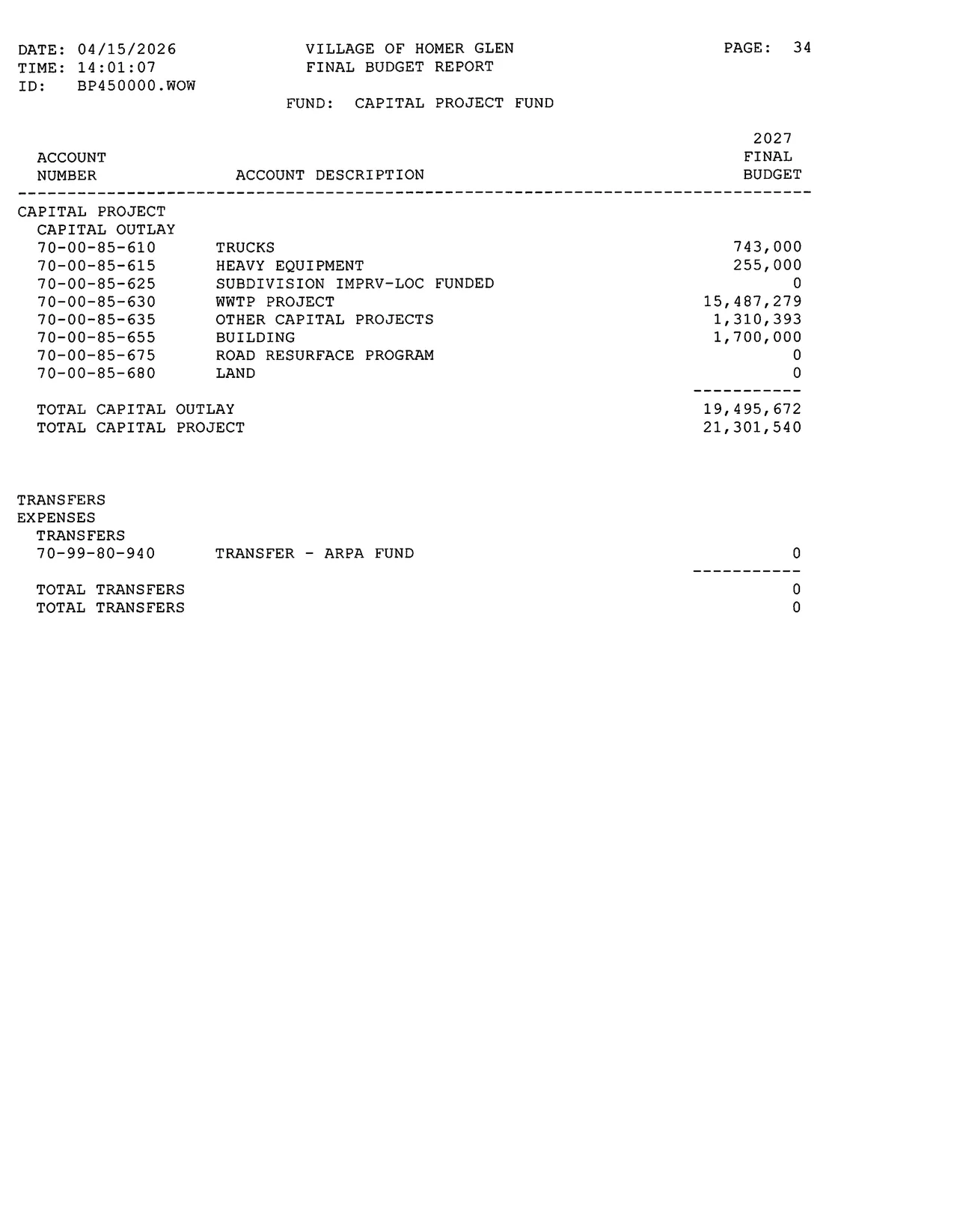

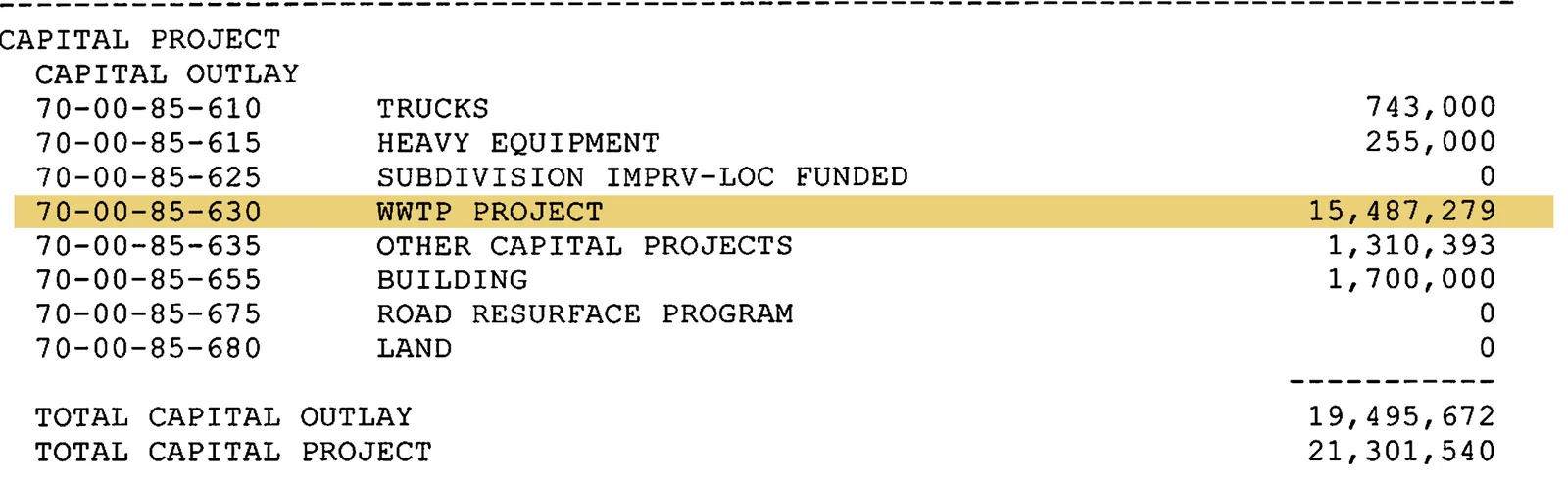

Capital Project Fund · Capital OutlayFY 2026-27 · adopted Apr 22, 2026
70-00-85-610TRUCKS743,000
70-00-85-615HEAVY EQUIPMENT255,000
70-00-85-625SUBDIVISION IMPRV-LOC FUNDED0
70-00-85-630WWTP PROJECT15,487,279
70-00-85-635OTHER CAPITAL PROJECTS1,310,393
70-00-85-655BUILDING1,700,000
70-00-85-675ROAD RESURFACE PROGRAM0
70-00-85-680LAND0
TOTAL CAPITAL OUTLAY19,495,672
79% WWTP project21% everything else in this year’s capital outlay
Transcribed from printed page 34 of the adopted budget, a scanned PDF with no searchable text, and checked against the printed total. The PDF is linked in the sources.

It is the largest single line in that budget, and it pays for more than the plant: the Village’s June 10, 2026 bid memo charges the $2,591,009.72 Cedar Road sewer extension to the same account. A draft presented five weeks earlier, on March 18, listed the plant and the Fiddyment Creek sewer work as separate projects — “WWTP - EST. (Construction & engineering)” at $14,871,000 and “FIDDYMENT CREEK (Construction & engineering)” at $2,097,148. The adopted budget reports by account, not by project, so those project lines do not appear in it.

Being precise about what this figure is: it is one account in one year’s budget, holding construction money for the plant and the Cedar Road sewer together, in a year that ends in April 2027 — before plant construction is scheduled to begin in January 2028. The Illinois EPA summary in Exhibit A puts the loan project — the plant plus a new lift station, force main and outfall — at $15,968,320.

On page 34 the plant appears only as “WWTP PROJECT,” and because the adopted budget is posted as a scan with no searchable text, even that can’t be found by searching. The Illinois EPA pages in the hearing packet are scans too. Figures from those scans were read off the page images, and the budget lines were checked against the budget’s printed totals; the six-year subsidy figure is our own sum of the state summary’s table. The other figures come from Village records (Board packets and minutes, budget drafts, the audited annual financial report and meeting videos) and news reports, all linked in the sources.

Where the idea came from

The Village has told residents it chose to build after a “detailed feasibility study and cost-benefit analysis.” Neither that study nor the September 2025 project plan is on the plant’s page on the Village website, and we haven’t found any Village communication that lays the options Lockport offered side by side, with their costs, for residents. Here’s what we found going back through the record.

The trouble was on the record by the fall of 2022. On September 28, 2022, the Board heard that Lockport’s Bonnie Brae plant was degrading rapidly; on October 26, 2022, then-Village Manager Carmen Maurella read the Board an email from Lockport: Lockport would not authorize any new connections or additional growth for Homer Glen. On January 11, 2023, under then-Mayor George Yukich, the Board voted 5–0 to fund an $18,250 Robinson Engineering feasibility study of a Village-owned treatment plant. That spring, before the April 2023 election, Maurella announced in the Village’s own Spring/Summer 2023 newsletter that he had put a team together to pursue a Village-owned facility, and trustee candidate Ruben Pazmino — running against Christina Neitzke-Troike’s slate, not with it — said in an April 3, 2023 election preview: “There was always an understanding that the Village would eventually develop its own system.” The idea predates this administration: the Board under Mayor Yukich voted 5–0 to fund the study (Pazmino, who was running against Neitzke-Troike’s slate, seconded it), the Village Manager announced the team, and the Board seated after the 2023 election — which kept three of those five yes votes — carried it forward.

To be clear: Maurella didn’t build the plant — he left in the summer of 2023. Every concrete step since — the site study, the land purchase, the Project Plan, the design contract — came before the Village Board from February 2024 on and was carried out under Village Manager Joe Baber. Mayor Neitzke-Troike presides over those meetings, but under Illinois law a village president ordinarily votes only to break a tie — so the votes that built this project belong to the trustees. What belongs to the Village’s leadership as a whole is telling residents, plainly, what it will cost them.

How we got here

2018
Homer Glen, the City of Lockport, and the Bonnie Brae–Forest Manor Sanitary District sign a 3-party intergovernmental agreement under which the flow from the Village’s own Fiddyment Creek sewer is treated at Lockport’s Bonnie Brae plant. The initial term runs to January 1, 2030.
May 25, 2022
The Village enters an agreement with Robinson Engineering for the “Fiddyment Creek Sanitary Sewer — Cedar Road Extension.” The sewer extension the Board would award for construction four years later was already being engineered.
September 28, 2022
At a Village Board meeting, the Board is told that the Village’s agreement with Lockport runs to 2030, and that Lockport’s Bonnie Brae plant, which treats the flow from the Village’s own sewer, is degrading rapidly.
October 26, 2022
At a Village Board meeting, Village Manager Carmen Maurella reads an email from Lockport: Lockport will not authorize any new connections or additional growth for Homer Glen.
January 11, 2023
Under then-Mayor George Yukich, the Village Board votes 5–0 to fund a Robinson Engineering feasibility study “to evaluate and estimate costs for the construction of a wastewater treatment facility within the Village of Homer Glen.” The proposal in the packet: $18,250.
Spring 2023 (before the April 4 election)
In the Village’s official newsletter, Village Manager Carmen Maurella announces he has put a team together to pursue Village ownership and operation of its own wastewater facility, published under then-Mayor George Yukich’s administration. The newsletter is dated only “Spring/Summer 2023,” but discusses that year’s election as still upcoming, so it was distributed before April 4.
April 3, 2023
In a Patch election preview, trustee candidate Ruben Pazmino says of Village sewer service: “There was always an understanding that the Village would eventually develop its own system.” Pazmino was running against Christina Neitzke-Troike’s slate, not with it — a Village-owned system was already the outgoing Board’s expectation, not this administration’s idea.
April 2023
Lockport gives notice that it will end the 2018 agreement at the close of its first term, January 1, 2030 — reportedly because its Bonnie Brae plant is at the end of its useful life.
April 26, 2023
Christina Neitzke-Troike is sworn in as Mayor, succeeding George Yukich. She was previously Village Clerk.
Summer 2023
Carmen Maurella resigns as Village Manager. Joe Baber becomes interim Village Manager.
February 15, 2024
At a Village Board meeting, Trustee Rose Reynders reports that she, Mayor Neitzke-Troike, Village Manager Joe Baber and Village Engineer Brett Westcott had met with Lockport, which laid out three options: “whether we want to build our own, whether we want to come on board with them with another IGA, and or if we want to go with Illinois American Water.” She adds: “We know that it takes five to six years to build a wastewater treatment plant… this is our top priority.” At the same meeting, the minutes record that Mayor Neitzke-Troike “addressed the wastewater treatment issue and noted that most of the discussions take place in executive session,” asking residents to contact the Village and “to not believe everything they read on Facebook.”
February 28, 2024
The Village Board approves an HR Green site feasibility study for the plant, not to exceed $20,240.
May 8, 2024
Village Board minutes record Mayor Neitzke-Troike saying that Illinois American Water, the wastewater project and 143rd Street are “three big topics residents keep asking about, unfortunately, some information can not be discussed publicly at the moment.”
June 25, 2024
Ordinance 24-033 authorizes the Village’s purchase agreement for roughly 30 acres near 159th Street & Gougar Road for a future plant site. The Village’s audited financial report describes it as a $50,000 payment for a 90-day exclusive option, with a purchase price of $4,000,000 to close.
October 2024
The warranty deed for the parcel is recorded. Purchase price: $4,000,000 — confirmed in the Village’s own Annual Comprehensive Financial Report.
January 22, 2025
The Village Board approves HR Green’s proposal for the plant’s formal Project Plan — the document that defines its size, service area, and cost. The Village’s audited financial report for that year lists the approval: HR Green “to complete the Waste Water Facilities Plan for Engineering in the amount of $64,320.”
September 24, 2025
At a Committee of the Whole budget discussion, the plant is described aloud as “about $15 million that we have budgeted in its entirety.”
February 25, 2026
The Village posts a news item: it is “excited to share information regarding its proposed wastewater treatment facility, which is scheduled to be completed by 2030,” and links a four-minute video narrated by Village Engineer Brett Westcott. The video says the first phase will serve “about 2500 residents,” that at full buildout the plant would serve about 3,000 acres, and that the project is “paid for by future growth and not current Illinois American Water customers.” Neither the post nor the video gives a cost, a monthly bill or a subsidy.
March 18, 2026
A draft of the FY2026-27 Village budget is presented. Its Capital Project Fund project list includes “WWTP - EST. (Construction & engineering)” at $14,871,000, plus a separate “FIDDYMENT CREEK (Construction & engineering)” at $2,097,148.
April 22, 2026
The Village Board adopts the FY2026-27 budget. In the Capital Project Fund, account 70-00-85-630, “WWTP PROJECT,” is budgeted at $15,487,279 — the largest single line in a capital budget that spends the fund down from $23.7 million to $6.2 million. The adopted budget reports by account, not by project, so the draft’s separate Fiddyment Creek line does not appear; the Cedar Road sewer contract is later charged to this same account.
June 10, 2026
The Village Board awards a $2,591,009.72 construction bid to Austin Tyler Construction to extend the Fiddyment Creek sanitary sewer trunk line along Cedar Road and 159th Street, “to be paid out of 70.00.85.630” — the WWTP PROJECT account. The Village says the project is set to receive $500,000 in grant funding if it is substantially complete by October 30, 2026, and that the extension “will assist in providing new users” for the planned plant.
June 16, 2026
The Illinois EPA issues its Project Summary of the Village’s state-loan project, drawn in part from the Village’s own project plan: a $15,968,320 project; a 20-year state loan at an estimated 2.16%, about $983,960 a year; projected customers of 114 new homes and one business; a flat residential sewer rate of $105 a month in 2030, rising to $125 in 2035; and a “proposed Village subsidy” of $561,135 in the first year.
July 8, 2026
The Village holds the required public hearing on the plan and the Illinois EPA summary. HR Green’s Ravi Jayaraman presents a 0.25 MGD first phase; the packet says the plant will be expanded to 0.5 MGD once it reaches 80% capacity. Resident Mike McGee, an engineer, questions the population and per-household flow assumptions behind the 0.25 MGD figure. Village Engineer Brett Westcott says the plant is not being designed to serve existing Illinois American Water sewer customers; its planning area runs from the plant site out to Parker Road. The projected monthly bill and the subsidy are not discussed aloud.
July 9, 2026
The Village updates its public Village Projects page. It lists six projects — two Parker Road bridges, the 151st Street expansion, Hero’s Trail, and two drainage jobs. Neither the wastewater treatment plant nor the Cedar Road sewer extension appears on it. The plant has its own page on the Village website, under Water & Sewer Service, with the February video and an undated roadmap document — and no cost, bill or subsidy.

Where the decisions were made

Village Board minutes · February 15, 2024
Mayor Neitzke-Troike “addressed the wastewater treatment issue and noted that most of the discussions take place in executive session.”
Village Board minutes · May 8, 2024
“…three big topics residents keep asking about, unfortunately, some information can not be discussed publicly at the moment.”

The Village Board’s own minutes are unusually direct about this. On February 15, 2024, the minutes record that Mayor Neitzke-Troike “addressed the wastewater treatment issue and noted that most of the discussions take place in executive session,” and asked residents to contact the Village for correct information and “to not believe everything they read on Facebook.” Three months later, on May 8, 2024, the minutes record her saying Illinois American Water, the wastewater project and 143rd Street were “three big topics residents keep asking about, unfortunately, some information can not be discussed publicly at the moment.”

Closed session is lawful and ordinary for buying land — nobody should pretend otherwise, and the Village was in the middle of a $4 million land deal whose price was voted in open session in June 2024. The problem is what came after. Residents were told by a trustee that this was the Village’s top priority, told by the Mayor that some of it couldn’t be discussed publicly, told not to believe everything they read on Facebook — and none of the follow-ups explained the bill or the subsidy. The Village’s February 2026 video says the plant will be paid for by “future growth and not current Illinois American Water customers”; it never mentions a subsidy. At the July 2026 hearing the state summary was part of the packet, but nobody said the projected bill or the subsidy out loud. They sit in a scanned state document in the packet.

And at that same February 2024 meeting, Trustee Rose Reynders described — in one report, recorded in the minutes — a choice the Village has not laid out for residents in any document since: Lockport had given the Village three options — build its own plant, sign a new agreement with Lockport, or go with Illinois American Water for sewage treatment. Homer Glen chose to build. That may have been the right answer. It was still a decision among three, with real tradeoffs, and residents were never walked through them.

What’s still unanswered

Much of what this page once listed as unknown turns out to be on paper, in the Illinois EPA summary. This is what genuinely remains open:

  • Where the “proposed Village subsidy” comes from — $561,135 in 2030, about $1.9 million through 2035 — and how it squares with the Village’s word that growth pays for the plant
  • Who pays while the plant fills up? — its first phase is sized for about 2,500 residents (the Village’s video), but the state summary projects 114 new homes and one business within five years, and its subsidy shrinks from $561,135 to $42,859 by 2035 on revenue the summary doesn’t explain. What happens to the bill and the subsidy if connections come slower?
  • The final cost — $15,968,320 is an estimate, and the Illinois EPA summary says the Village “will reevaluate the projected user rates once actual costs are known”
  • Whether homes on septic could ever be required to connect — the state summary says they can connect “when they are ready” and no Village ordinance we have found requires it, but a state rule generally bars approving a new or renovated septic system when a permitted sewer is available within 300 feet, with limited exceptions (77 Ill. Adm. Code 905.20(e))

Questions & answers

Is the Village taking over my drinking water?
No. This project treats sewage (wastewater) only. It changes nothing about where your drinking water comes from — Illinois American Water where it serves, your own well elsewhere. The confusion is understandable: Illinois American Water also runs three wastewater plants inside Homer Glen (Oak Valley, Derby Meadows, Chickasaw Hills). Those are a different matter from the Village’s own new plant.
Who is the plant actually for?
By the Illinois EPA’s summary of the Village’s plan, dated June 16, 2026, the plant “will serve” the commercial customers Lockport treats today “as well as 114 residential units that will be developed within the next 5 years,” and its projected customer count, printed just below its rate and subsidy table, is 114 residential connections and one commercial customer. Homes on septic can connect “when they are ready.” The Village’s own February 2026 video describes it larger: a first phase serving “about 2500 residents,” growing in phases to about 3,000 acres at full buildout. At the July 8, 2026 hearing, Village Engineer Brett Westcott said the plant is not being designed to serve existing Illinois American Water sewer customers, and that its planning area runs from the plant site out to Parker Road, “this largely undeveloped area and unserved area.” A consultant’s January 2025 proposal bounds that area by 151st and 159th Streets. The plant starts at 0.25 million gallons a day and is planned to expand to 0.5 once it reaches 80% capacity.
Why does Homer Glen need to build its own plant at all?
Under a 2018 agreement, Lockport treats the flow from the Village’s own sewer — today, one commercial customer. In 2023 Lockport gave notice that it will end that agreement on January 1, 2030, and it plans to turn its Bonnie Brae plant into a lift station. Without its own plant, the Village would need another outside provider — a new agreement with Lockport, or Illinois American Water — both for that flow and for the 114 new homes and 159th Street parcels it is planning for; under the current agreement, Lockport had already refused any new connections in 2022. Homes already on Illinois American Water sewer, or on septic, are not what this deadline is about.
Whose idea was this?
Not this administration’s. The problem was raised in open session in the fall of 2022; on October 26, the Village Manager read the Board an email from Lockport refusing any new connections or additional growth for Homer Glen. In January 2023, under then-Mayor George Yukich, the Board voted 5–0 to fund a feasibility study of a Village-owned plant. That spring, before Christina Neitzke-Troike became Mayor, then-Village Manager Carmen Maurella announced in the Village newsletter that he had put a team together to pursue one, and trustee candidate Ruben Pazmino — running against her slate, not with it — said a Village-owned system had “always” been expected. The Village has explained why it needs a plant, and its February 2026 video says it chose to build after a feasibility study and a cost-benefit analysis. Neither that study nor the September 2025 project plan is posted on the plant’s page on the Village website; both should be.
So did the current administration start this project?
The idea predates it. Every concrete step toward an actual plant — the HR Green site study, the land purchase, the Project Plan, the design contract — came before the Village Board from February 2024 on, about half a year after Maurella left, and was carried out under Village Manager Joe Baber. Under Illinois law a village president ordinarily votes only to break a tie, so those approvals belong to the Board of Trustees, not to the Mayor personally. Maurella gets credit for starting it; the Board and Village staff did the building; and what still hasn’t happened is a plain explanation of the “proposed Village subsidy” — about $1.9 million over six years, source unstated — set against the Village’s own word that the plant will be paid for by future growth.
Has Mayor Neitzke-Troike talked about this project?
Some — and the record of how is worth reading. On February 15, 2024, Village Board minutes record that she “addressed the wastewater treatment issue and noted that most of the discussions take place in executive session,” and asked residents to contact the Village for correct information and “to not believe everything they read on Facebook.” On May 8, 2024, the minutes record her saying that Illinois American Water, the wastewater project and 143rd Street are “three big topics residents keep asking about, unfortunately, some information can not be discussed publicly at the moment.” On February 25, 2026 the Village posted a news item saying it was “excited to share information” about the facility and pointing residents to a video that gives the first phase’s size and a funding approach, but no cost, no bill and no subsidy. Her Message from the Mayor in the Spring/Summer 2026 newsletter doesn’t mention the plant; it covers her opposition to an Illinois American Water rate increase. Executive session is lawful and routine for land acquisition, and the question isn’t whether closed sessions were allowed. The plan has since come to open session. But the projected monthly bill and the proposed Village subsidy have reached residents only as scanned state pages — in the hearing packet and on the hearing’s slides — with neither figure said aloud.
Is this connected to the Badger rezoning near Cedar Glen?
The plant site and the Badger rezoning request are in the same general area of 159th Street, but we have not found any document connecting them. That request was a Will County case (ZC-26-020), and the Village opposed it through Resolution 26-014 on May 15, 2026 — a resolution about that county case only. We’re not going to imply a link the record doesn’t support.
What has the Village said this will cost?
Out loud, in round numbers: at a September 24, 2025 Committee of the Whole meeting, the plant was described as “about $15 million that we have budgeted in its entirety.” In writing, the Village’s yearly budgets have carried the plant at different figures — $14,095,000 in FY2024-25, a year that also covered buying the site, and $15,487,279 in the FY2026-27 budget the Board adopted on April 22, 2026, in an account that also pays for the Cedar Road sewer extension. The Illinois EPA’s June 16, 2026 summary of the Village’s plan puts the loan project at $15,968,320, to be borrowed over 20 years at an estimated 2.16% — about $983,960 a year. None of those figures appears in the Village’s February 2026 video or news post about the plant, or on the plant’s own page on the Village website.
Will my sewer bill go up?
It depends on whose sewer you are on. If Illinois American Water handles your sewage, the Illinois Commerce Commission sets that rate in its rate cases, and the Village’s own video says this project will not affect existing Illinois American Water customers. If you are on septic, you have no sewer bill today — see the next question. The customers the Illinois EPA summary projects are the Village’s own sewer customers: today one business, and within five years 114 new homes. For those homes it projects a flat $105 a month in 2030, rising to $125 in 2035. To repay the loan it adds a per-1,000-gallon charge to commercial users and “a proposed Village subsidy” — money paid by the Village, not added to customers’ bills — of $561,135 in 2030, falling to $42,859 in 2035. The summary does not say where the subsidy money comes from. The Village’s audited statements say its sewer user charges are set by the Board of Trustees — no referendum, and no state rate case.
Could I be required to connect if I’m on a septic system?
No Village ordinance we have found requires it. The Illinois EPA summary says the plant “will also allow the private septic system users to connect to the Village’s treatment system when they are ready,” and a 2021 Village staff memo on its water and sewer rates speaks of well-and-septic homes “that choose to connect.” But one state rule matters: under the Illinois Private Sewage Disposal Code (77 Ill. Adm. Code 905.20(e)), a new or renovated septic system “shall not be approved” where a sewer operated under an Illinois EPA permit is available — for a home, generally one within 300 feet, unless a physical barrier or local ordinance prevents connection or an ordinary individual line can’t reach. So if your septic system ever has to be replaced and a permitted sewer line runs within 300 feet of your property, connecting may be your only option. And Homer Glen is a home-rule village with broad power over its own sewer system, so a future Board could go further by ordinance. That is the question the Village should answer in writing before the plant is built, not after.
Why wouldn’t residents get a vote on something this size?
Illinois villages adopt their budgets by Board vote; no referendum is involved. Homer Glen is also a home-rule municipality, which generally lets the Board borrow without a referendum, within limits set by state law. And the Village’s audited statements say sewer user charges are set by the Board of Trustees — not by referendum, and not by the Illinois Commerce Commission, which regulates Illinois American Water. That is exactly why residents deserve a plain explanation of the cost, the bill and the subsidy before those votes happen, not after.
Was there ever a choice, or did this have to happen?
There was a choice. According to Village Board minutes from February 15, 2024, Lockport presented Homer Glen with three options: build its own plant, sign a new intergovernmental agreement with Lockport, or go with Illinois American Water for sewage treatment. The Village chose to build. That may well have been the right call — tying the Village to a neighbor that is retiring the plant that serves it is not much of a plan, and Illinois American Water’s rates are already the reason many residents are angry. But beyond Trustee Reynders naming the three options in that one report, we have not found any Village communication that lays them out for residents with their costs and tradeoffs.
What does Heidi think should happen?
A Village-owned plant is very likely a genuine, necessary infrastructure need — this isn’t a project Heidi is asking the Village to cancel. What she is asking for is plain disclosure: put the cost, the loan and the projected bill on the plant’s own page on the Village website and in the Village newsletter, not only in a scanned state summary; explain the proposed Village subsidy — where the money comes from, how it fits the Village’s word that growth pays for the plant, and what happens if fewer than 114 homes connect; give residents on septic an answer in writing; and set the Village sewer rate in public with the math shown, since the same Board that approves the plant sets that rate. The numbers exist. Residents shouldn’t have to find them as scanned pages in a hearing packet — or be told not to believe what they read on Facebook while the numbers sit in documents nobody handed them.
Sources
  1. Illinois EPA — Project Summary and Preliminary Environmental Impacts Determination for the Village of Homer Glen’s loan application (Loan Project L177782, New Wastewater Treatment Facility), dated June 16, 2026 — scanned pages 5–10 of the Village’s July 8, 2026 Board packet. Project cost estimate $15,968,320; 20-year Water Pollution Control Loan at an estimated 2.16%, about $983,960 a year; repayment through customer billing and “a proposed Village subsidy”; projected residential rate $105/month (2030) to $125/month (2035); projected customers “114 residential connections, 1 commercial customer”; septic users may connect “when they are ready.” homerglenil.org (PDF, 147 pp.)
  2. Robinson Engineering for the Village of Homer Glen — “Wastewater Treatment Facility Feasibility Analysis,” June 29, 2023 DRAFT, posted on the Village website (p. 3: developers had approached the Village, which was “limited in its ability to process development applications” without “economical and long-term infrastructure being readily available”; p. 6, Table 1, “Anticipated Short Term Population Growth in Service Area”: a “Conceptual Site Plan showing 114 residential Lots, no commercial” on 50 acres, 159th Street east of Cedar Road, called “a possible short-term forecast of development”). homerglenil.org (PDF)
  3. Village of Homer Glen — “Wastewater Treatment: A Plan For Homer Glen,” video narrated by Village Engineer Brett Westcott, posted February 25, 2026 (first phase serving “about 2500 residents”; about 3,000 acres at full buildout; funding from “low-interest loans, potential federal grants, and connection fees from new users”; “paid for by future growth and not current Illinois American Water customers”; no cost, bill or subsidy figure). Quotes from the video’s captions. youtube.com
  4. Village of Homer Glen — “Homer Glen Water Treatment Vision,” the plant’s own page under Water & Sewer Service (the roadmap document and the February 2026 video; no cost, bill or subsidy figure). homerglenil.org
  5. Village of Homer Glen — Village Board meeting video, July 8, 2026 (public hearing: HR Green’s Ravi Jayaraman; resident Mike McGee; Village Engineer Brett Westcott on the service area). youtube.com
  6. Village of Homer Glen — ADOPTED Budget, Fiscal Year May 1, 2026 to April 30, 2027 (adopted April 22, 2026). Capital Project Fund, account 70-00-85-630 “WWTP PROJECT,” $15,487,279, printed page 34. This PDF is a scan with no searchable text layer. homerglenil.org (PDF)
  7. Village of Homer Glen — FY27 Budget Draft 1 (Admin & Finance Committee workshop, March 18, 2026) and Draft 2 (the April 8, 2026 public-hearing draft): “WWTP - EST. (Construction & engineering) $14,871,000” and “FIDDYMENT CREEK (Construction & engineering) $2,097,148.” homerglenil.org (Draft 1, PDF)
  8. Village of Homer Glen — FY27 Budget Draft 2, the April 8, 2026 public-hearing draft, with the same Capital Project Fund project lines. homerglenil.org (Draft 2, PDF)
  9. Village of Homer Glen — Committee of the Whole packet, September 24, 2025 (capital-projects list: “WWTP - EST. (Construction & engineering) $10,728,463”). homerglenil.org (PDF)
  10. Village of Homer Glen — Village Board packet, April 24, 2024: FY2024-25 final budget report, account 70-00-85-630 “WWTP PROJECT,” $14,095,000. homerglenil.org (PDF)
  11. Village of Homer Glen — Committee of the Whole meeting video, September 24, 2025 (the plant described as “about $15 million that we have budgeted in its entirety”). youtube.com
  12. Village of Homer Glen — Village Board packet, June 10, 2026: award of the $2,591,009.72 Austin Tyler Construction bid for the Cedar Road Fiddyment Creek Sanitary Sewer Extension, “to be paid out of 70.00.85.630”; $500,000 grant “pending substantial completion by October 30th, 2026”; the extension “will assist in providing new users” for the planned plant. homerglenil.org (PDF)
  13. Village of Homer Glen — Village Board packet, January 22, 2025: the HR Green agreement for the plant’s Project Plan (“so the Village of Homer Glen can begin treating the wastewater generated in the Fiddyment Creek service area by the Year 2030”) and Strand Associates’ competing proposal (January 2, 2025), which describes that area as “a largely undeveloped area of the village generally bound by 151st Street, 159th Street, Gougar Road, and Parker Road.” homerglenil.org (PDF)
  14. Village of Homer Glen — Annual Comprehensive Financial Report, year ended April 30, 2025 (audited). Source for the enterprise-fund rate-setting language, the $50,000 land option and $4,000,000 purchase, and the $64,320 HR Green Waste Water Facilities Plan approval. homerglenil.org (PDF)
  15. Village of Homer Glen — Village Board minutes, September 28, 2022 (the Board is told the Lockport agreement runs to 2030 and that Lockport’s Bonnie Brae plant is degrading rapidly). homerglenil.org (PDF)
  16. Village of Homer Glen — Village Board minutes, October 26, 2022 (the Village Manager reads Lockport’s email refusing new connections or additional growth for Homer Glen). homerglenil.org (PDF)
  17. Village of Homer Glen — Village Board minutes, January 11, 2023 (5–0 vote to fund a Robinson Engineering feasibility study “to evaluate and estimate costs for the construction of a wastewater treatment facility”; the $18,250 proposal is in that night’s packet). homerglenil.org (PDF)
  18. Village of Homer Glen — Spring/Summer 2023 newsletter, “Carmen’s Corner” (p. 3, Village Manager Carmen Maurella’s column announcing the wastewater-facility team). homerglenil.org (PDF)
  19. Patch — “2 Slates Face Off For Homer Glen Village Trustee, Clerk: Election 2023” (Ruben Pazmino quote, April 3, 2023). patch.com
  20. Patch — “Lockport Will Terminate Waste Water Agreement With Homer Glen In 2030” (April 20, 2023). patch.com
  21. Patch — “New Homer Glen Mayor, Trustees Sworn In Wednesday” (posted April 27, 2023; reports that Neitzke-Troike and new trustees were sworn in on April 26, before a Board meeting that had been expected to be Yukich’s last). patch.com
  22. Patch — Homer Glen Village Manager resignation coverage (August 2023). patch.com
  23. Village of Homer Glen — Village Board meeting packet, June 12, 2024, containing the approved minutes of the February 15, 2024 and May 8, 2024 Board meetings (Trustee Reynders on Lockport’s three options; Mayor Neitzke-Troike on executive session and on information that “can not be discussed publicly”). homerglenil.org (PDF)
  24. Village of Homer Glen — Village Board packet, March 24, 2021: staff memo on Ordinance 21-016 (Village water and sewer rates), whose non-metered rates apply to homes on well and septic “that choose to connect to the Village’s sanitary sewer system.” homerglenil.org (PDF)
  25. Village of Homer Glen — Major Contracts & Agreements register (HR Green site study, land purchase, Project Plan agreement). homerglenil.org
  26. Village of Homer Glen — “Homer Glen’s Waste Water Treatment Plant and Visions for the Village” (Village roadmap document; names Robinson Engineering for the feasibility study, states the ~1 acre per MGD sizing rule, and raises a temporary “pop-up” plant as a contingency). homerglenil.org (PDF)
  27. Village of Homer Glen — news item, “Wastewater Treatment Plan,” February 25, 2026. homerglenil.org
  28. Village of Homer Glen — Village Projects page (updated July 9, 2026; lists six projects, none of them the wastewater plant or the Cedar Road sewer extension). homerglenil.org
  29. Village of Homer Glen — detailed history of lake water and sewer service. homerglenil.org
  30. Village of Homer Glen — Mayor’s Office (confirms “Village President,” commonly called Mayor). homerglenil.org
  31. Patch — “Homer Glen Approves $2.5M Sanitary Sewer Line Project” (published June 11, 2026, reporting the Board’s June 10 vote on the $2,591,009.72 Austin Tyler Construction bid). patch.com
  32. Illinois Administrative Code, 77 Ill. Adm. Code 905.20(e) (Private Sewage Disposal Code): new or renovated private sewage disposal systems “shall not be approved” where a sanitary sewer operated under Illinois EPA permit is available — for a residential property, generally within 300 feet, with exceptions for physical barriers, local ordinances and connections an individual line can’t make. ilga.gov
  33. Map: Village boundary and road positions © OpenStreetMap contributors, available under the Open Database License (openstreetmap.org/copyright). The service area is drawn approximately from the Village’s own descriptions, not from a parcel map. openstreetmap.org

Stay informed

We’ll update this page as the subsidy’s source, the new plant’s sewer rate and the septic answer become public.
